While our grid may be showing its age, this is the perfect time to shift from reacting to problems to getting ahead of them.

Did you catch those images of idle generators that CenterPoint had on standby during Hurricane Beryl? With over 2 million people in the Houston area left in the dark, many were wondering, "if the generators are ready, why didn’t they get used?" It seems like power outages are becoming just as common as the severe storms themselves.

But as Ken Medlock, Senior Director of the Baker Institute Center for Energy Studies (CES) explains, it's not a simple fix. The outages during Hurricane Beryl were different from what we saw during Winter Storm Uri. This time, with so many poles and wires down, those generators couldn’t be put to use. It’s a reminder that each storm brings its own set of challenges, and there’s no one-size-fits-all solution when it comes to keeping the lights on. While extreme weather is one of the leading threats to our electric grid, it's certainly not the only one adding strain on our power infrastructure.

The rapid rise of artificial intelligence (AI) and electric vehicles (EVs) is transforming the way we live, work, and move. Beneath the surface of these technological marvels lies a challenge that could define the future of our energy infrastructure: they all depend on our electrical grid. As AI-powered data centers and a growing fleet of EVs demand more power than ever before, our grid—already under pressure from extreme weather events and an increasing reliance on renewable energy—faces a critical test. The question goes beyond whether our grid can keep up, but rather focuses on how we can ensure it evolves to support the innovations of tomorrow without compromising reliability today. The intersection of these emerging technologies with our aging energy infrastructure poses a dilemma that policymakers, industry leaders, and consumers must address.

Julie Cohn, Nonresident Fellow at the Center for Energy Studies at the Baker Institute for Public Policy, presents several key findings and recommendations to address concerns about the reliability of the Texas energy grid in her Energy Insight. She suggests there’s at least six developments unfolding that will affect the reliability of the Texas Interconnected System, operated by the Electric Reliability Council of Texas (ERCOT) and the regional distribution networks operated by regulated utilities.

Let’s dig deeper into some of these issues:

AI

AI requires substantial computational power, particularly in data centers that house servers processing vast amounts of data. These data centers consume large amounts of electricity, putting additional strain on the grid.

According to McKinsey & Company, a single hyperscale data center can consume as much electricity as 80,000 homes combined. In 2022, data centers consumed about 200 terawatt-hours (TWh), close to 4 percent, of the total electricity used in the United States and approximately 460 TWh globally. That’s nearly the consumption of the entire State of Texas, which consumed approximately 475.4 TWh of electricity in the same year. However, this percentage is expected to increase significantly as demand for data processing and storage continues to grow. In 2026, data centers are expected to account for 6 percent, almost 260 TWh, of total electricity demand in the U.S.

EVs

According to the Texas Department of Motor Vehicles, approximately 170,000 EVs have been registered across the state of Texas as of 2023, with Texas receiving $408 million in funding to expand its EV charging network. As Cohn suggests, a central question remains: Where will these emerging economic drivers for Texas, such as EVs and AI, obtain their electric power?

EVs draw power from the grid every time they’re plugged in to charge. This may come as a shock to some, but “the thing that’s recharging EV batteries in ERCOT right now, is natural gas,” says Medlock. And as McKinsey & Company explains, the impact of switching to EVs on reducing greenhouse gas (GHG) emissions will largely depend on how much GHG is produced by the electricity used to charge them. This adds a layer of complexity as regulators look to decarbonize the power sector.

Depending on the charger, a single EV fast charger can pull anywhere from 50 kW to 350 kW of electricity per hour. Now, factor in the constant energy drain from data centers, our growing population using power for homes and businesses, and then account for the sudden impact of severe environmental events—which have increased in frequency and intensity—and it’s clear: Houston… we have a problem.

The Weather Wildcard

Texas is gearing up for its 2025 legislative session on January 14. The state's electricity grid once again stands at the forefront of political discussions. The question is not just whether our power will stay on during the next winter storm or scorching summer heatwave, but whether our approach to grid management is sustainable in the face of mounting challenges. The events of recent years, from Winter Storm Uri to unprecedented heatwaves, have exposed significant vulnerabilities in the Texas electricity grid, and while legislative measures have been taken, they have been largely patchwork solutions.

Winter Storm Uri in 2021 was a wake-up call, but it wasn’t the first or last extreme weather event to test the Texas grid. With deep freezes, scorching summers, and unpredictable storms becoming the norm rather than the exception, it is clear that the grid’s current state is not capable of withstanding these extremes. The measures passed in 2021 and 2023 were steps in the right direction, but they were reactive, not proactive. They focused on strengthening the grid against cold weather, yet extreme heat, a more consistent challenge in Texas, remains a less-addressed threat. The upcoming legislative session must prioritize comprehensive climate resilience strategies that go beyond cold weather prep.

“The planners for the Texas grid have important questions to address regarding anticipated weather extremes: Will there be enough energy? Will power be available when and where it is needed? Is the state prepared for extreme weather events? Are regional distribution utilities prepared for extreme weather events? Texas is not alone in facing these challenges as other states have likewise experienced extremely hot and dry summers, wildfires, polar vortexes, and other weather conditions that have tested their regional power systems,” writes Cohn.

Renewable Energy and Transmission

Texas leads the nation in wind and solar capacity (Map: Energy, Environment, and Policy in the US), however the complexity lies in getting that energy from where it’s produced to where it’s needed. Transmission lines are feeling the pressure, and the grid is struggling to keep pace with the rapid expansion of renewables. In 2005, the Competitive Renewable Energy Zones (CREZ) initiative showed that state intervention could significantly accelerate grid expansion. With renewables continuing to grow, the big question now is whether the state will step up again, or risk allowing progress to stall due to the inadequacy of the infrastructure in place. The legislature has a choice to make: take the lead in this energy transition or face the consequences of not keeping up with the pace of change.

Conclusion

The electrical grid continues to face serious challenges, especially as demand is expected to rise. There is hope, however, as regulators are fully aware of the strain. While our grid may be showing its age, this is the perfect time to shift from reacting to problems to getting ahead of them.

As Cohn puts it, “In the end, successful resolution of the various issues will carry significant benefits for existing Texas industrial, commercial, and residential consumers and have implications for the longer-term economic attractiveness of Texas. Suffice it to say, eyes will be, and should be, on the Texas legislature in the coming session.”

------------

Scott Nyquist is a senior advisor at McKinsey & Company and vice chairman, Houston Energy Transition Initiative of the Greater Houston Partnership. The views expressed herein are Nyquist's own and not those of McKinsey & Company or of the Greater Houston Partnership. This article originally ran on LinkedIn on September 11, 2024.

The GHRI Phase Two will lead to more than 125 million fewer outage minutes annually, according to CenterPoint. Photo via centerpoint.com

CenterPoint’s Greater Houston Resiliency Initiative makes advancements on progress

step by step

CenterPoint Energy has released the first of its public progress updates on the actions being taken throughout the Greater Houston 12-county area, which is part of Phase Two of its Greater Houston Resiliency Initiative.

The GHRI Phase Two will lead to more than 125 million fewer outage minutes annually, according to CenterPoint.

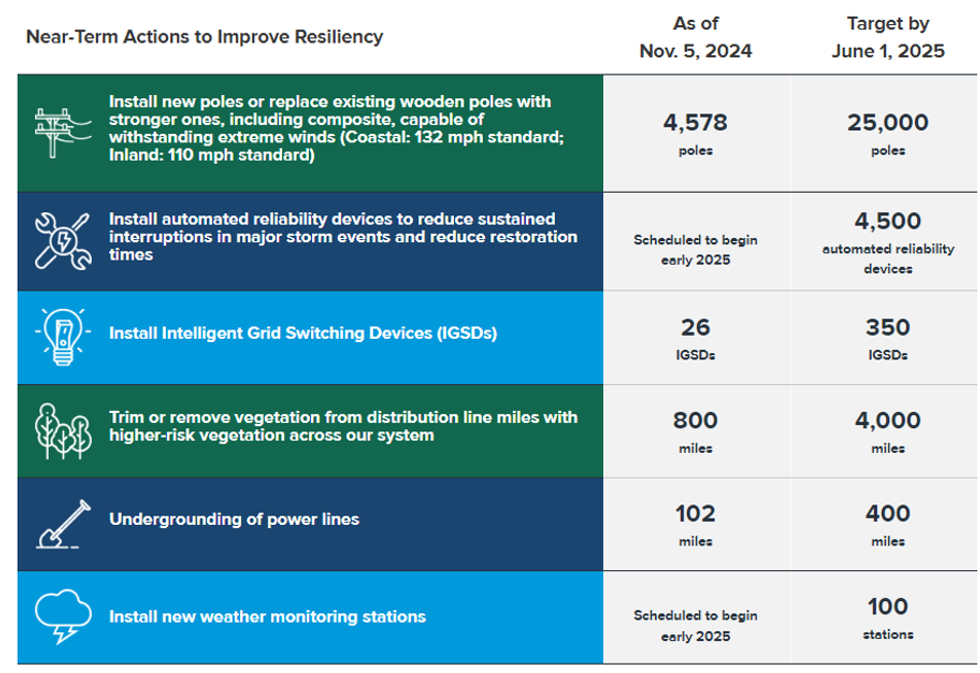

According to CenterPoint, they have installed around 4,600 storm-resilient poles, installed more than 100 miles of power lines underground, cleared more than 800 miles of hazardous vegetation to improve reliability, and installed more self-healing automation all during the first two months of the program in preparation for the 2025 hurricane season.

"This summer, we accomplished a significant level of increased system hardening in the first phase of the Greater Houston Resilience Initiative,” Darin Carroll, senior vice president of CenterPoint Energy's Electric Business, says in a news release.

”Since then, as we have been fully engaged in delivering the additional set of actions in our second phase of GHRI, we continue to make significant progress as we work toward our ultimate goal of becoming the most resilient coastal grid in the country,” he continues.

The GHRI is a series of actions to “ strengthen resilience, enable a self-healing grid and reduce the duration and impact of power outages” according to a news release. The following progress through early November include:

The second phase of GHRI will run through May 31, 2025. During this time, CenterPoint teams will be installing 4,500 automated reliability devices to minimize sustained interruptions during major storms, reduce restoration times, and establish a network of 100 new weather monitoring stations. CenterPoint plans to complete each of these actions before the start of the next hurricane season.

“Now, and in the months to come, we will remain laser-focused on completing these critical resiliency actions and building the more reliable and more resilient energy system our customers expect and deserve," Carroll adds.

CenterPoint also announced that it has completed all 42 of the critical actions the company committed to taking in the aftermath of Hurricane Beryl. Some of the actions were trimming or removing higher-risk vegetation from more than 2,000 power line miles, installing more than 1,100 more storm-resilient poles, installing over 300 automated devices to reduce sustained outages, launching a new, cloud-based outage tracker, improving CenterPoint's Power Alert Service, hosting listening sessions across the service area and using feedback.

In October, CenterPoint Energy announced an agreement with Artificial Intelligence-powered infrastructure modeling platform Neara for engineering-grade simulations and analytics, and to deploy Neara’s AI capabilities across CenterPoint’s Greater Houston service area.

Don Daigler will be tasked to lead CenterPoint Energy's yearly work in preparation for, response to and recovery from all emergencies, which includes both natural disasters and man-made events. Photo via CenterPoint Energy/LinkedIn

CenterPoint names 40-year industry veteran as exec for emergency response

onboarding

CenterPoint Energy announced the hiring of industry veteran Don Daigler as the new senior vice president of CenterPoint’s Emergency Preparedness and Response.

Daigler will be tasked to lead the company’s yearly work in preparation for, response to and recovery from all emergencies, which includes both natural disasters and man-made events. Daigler and his team will coordinate with all public safety partners.

“I’m pleased to join CenterPoint Energy and lead its Emergency Preparedness and Response team to transform how we prepare, mitigate and respond to the impacts of hurricanes, extreme weather and other emergencies,” Daigler says in a news release. ”The year-round work of our team will help position CenterPoint to deliver the service our customers expect and deserve before, during and after emergencies when the need is greatest.”

He brings over 40 years of experience across private and public sectors in emergency management, and national security and business resiliency. Daigler most recently was the CEO and founder of Resilience Advisory Services, which specialized in advancing resilience efforts across critical infrastructure sectors. He also served as director of the Federal Emergency Management Agency’s Response Planning Division and chief of FEMA’s Tactical Incident Support Branch. Daigler also had leadership roles for the Environmental Protection Agency , National Nuclear Security Administration, and Reynolds Electrical and Engineering Company.

This leadership position “underscores CenterPoint’s commitment to improving its emergency response and coordination following Hurricane Beryl, and represents completing another of the more than 40 commitments CenterPoint made as part of the Greater Houston Resiliency Initiative (GHRI) in August,” according to CenterPoint. CenterPoint completed 41 of the 42 overall commitments. The last commitment is scheduled to be completed by the end of 2024.

“After Hurricane Beryl, we heard loud and clear the calls to improve our preparedness for storms and other emergencies,” President and CEO of CenterPoint Energy Jason Wells adds. “Don will play a leading role in enhancing these operations ahead of the 2025 hurricane season and making CenterPoint a model for other utilities in emergency management and preparedness. His hiring underscores our commitment to better serve our customers in the energy capital of the world and building the most resilient coastal grid in the country.”

Neara’s AI-enabled simulation and analytics platform can help CenterPoint reduce customer outages and accelerate restoration efforts. Photo via Getty Images

CenterPoint partners with AI company to help reduce outages, help restoration

hi, tech

CenterPoint Energy announced an agreement with Artificial Intelligence-powered infrastructure modeling platform Neara for engineering-grade simulations and analytics, and to deploy Neara’s AI capabilities across CenterPoint’s Greater Houston service area.

“We are thrilled to collaborate with CenterPoint as they lead the charge in addressing today’s most existential energy challenges,” Robert Brook, senior vice president and managing director of Neara Americas, says in a news release.

Neara’s AI-enabled simulation and analytics platform can help CenterPoint reduce customer outages and accelerate restoration efforts. The technology can support CenterPoint’s efforts to address higher-risk vegetation along power lines, and identify equipment upgrades. Upgrades can include pole replacements or reinforcements. The platform will help CenterPoint to prioritize “assets and locations where grid hardening improvements will help optimize system-wide benefit,” per the release.

"Our 3D digital modeling technology will help CenterPoint proactively reduce customer outages by simulating severe weather events, such as hurricanes, tropical storms, heat waves and flash floods, and their potential impact on the utility’s infrastructure,” Brook says in the release.

CenterPoint recently announced the ahead of schedule completion of core resiliency actions as part of the first phase of its Greater Houston Resiliency Initiative (GHRI). This included a series of targeted actions to improve the resiliency of CenterPoint Houston Electric's grid with a second phase of GHRI that will include strategic undergrounding, system hardening, self-healing grid technology and enhancements to the company's outage tracker. These efforts are all part of a longer-term resilience plan.

“Leveraging technology and AI to deliver better outcomes for our customers and communities is a significant part of the commitment we made after Hurricane Beryl,” adds CenterPoint President and CEO Jason Wells in a news release. “By simulating the potential impact of severe weather events on our infrastructure and customers, Neara’s platform and tools will inform our plans and actions before, during and after major weather events to help reduce the impact and duration of power outages. Understanding how weather scenarios and their risks could affect our operations will position us to be several steps ahead on our preparedness and response.”

In the wake of Hurricane Beryl, CenterPoint Energy announced its Greater Houston Resiliency Initiative. The initiative will include an “accelerated timeline to execute specific actions to strengthen electric infrastructure across Houston, and more than 40 critical actions in total to strengthen the electric grid, and improve the company's customer communications and emergency coordination before the next hurricane,” according to the company.

Houstonians can expect rain and potential electricity outages this week. The region recently experienced devastation from Hurricane Beryl. Photo via Getty Images

Tropical system expected to strengthen in Gulf of Mexico, CenterPoint reports preparation plans

incoming

Update: Space City Weather reported Monday morning that the storm has turned, and Houston is likely to see minimal effects.

A tropical system in the southwestern Gulf of Mexico was expected to strengthen this week into a tropical storm and dump heavy rains onto Mexico and Texas before reaching the U.S. as a potential hurricane, the National Weather Service said Sunday.

The system, about 340 miles (545 kilometers) south-southeast of the mouth of the Rio Grande, had maximum 50 mph wind speeds (85 kilometers per hour) on Sunday and was forecast to drift slowly northwestward. Forecasters said it was too early to pinpoint the exact track of the storm and its potential impacts but warned that the upper Texas and Louisiana coastlines could see damaging winds and storm surges beginning Tuesday evening.

Houston-based CenterPoint Energy released a statement about its preparation for potential severe weather in the Greater Houston area, as well as in Louisiana and Mississippi. The company reported having 2,000 frontline workers and over 600 vegetation management personnel actively conducting pre-storm activities — with about 700 additional vegetation management personnel and 5,000 additional frontline workers if needed for response.

"While our weather experts work to determine the path, intensity and timing of the tropical activity, we remain vigilant and are fully focused on executing on our storm preparation plan. We are in the process of mobilizing all of our available resources and mutual assistance resources from other utility companies so we will be prepared to safely and quickly restore power to our customers should this tropical system impact our area," Darin Carroll, senior vice president of electric business, says in the release.

Texas Gov. Greg Abbott put state emergency responders on increased readiness and warned of the potential of flash flooding and heavy rains.

“Texas will continue to closely monitor weather conditions to protect the well-being of Texans,” Abbott said in a statement.

Donald Jones, a meteorologist with the National Weather Service in Lake Charles, Louisiana, said during a weather briefing Saturday night that parts of southeast Texas and southwest Louisiana should expect a “whole lot” of rain in the middle and later part of this week.

The tropical disturbance comes after an unusually quiet August and early September in the current Atlantic hurricane season, which runs through Nov. 30. The season was set to peak on Tuesday, Jones said.

So far, there have been five named storms this hurricane season, including Hurricane Beryl, which knocked out power to nearly 3 million homes and businesses in Texas — mostly in the Houston area — in July. Experts had predicted one of the busiest Atlantic hurricane seasons on record.

The next named storm would be called Francine.

In a report issued last week, researchers at Colorado State University cited several reasons for the lull in activity during the current hurricane season, including extremely warm upper level temperatures resulting in stabilization of the atmosphere and too much easterly wind shear in the eastern Atlantic.

“We still do anticipate an above-normal season overall, however, given that large-scale conditions appear to become more favorable around the middle of September,” according to the report.

Last month, the National Oceanic and Atmospheric Administration updated its outlook but still predicted a highly active Atlantic hurricane season. Forecasters tweaked the number of expected named storms from 17 to 25 to 17 to 24.

CenterPoint has committed to "the largest investment in Greater Houston infrastructure in the company's nearly 160-year history." Photo via Getty Images

CenterPoint Energy announces $5B expanded resiliency plan

doubling down

CenterPoint Energy disclosed that it's completed its core resiliency actions first phase of its Greater Houston Resiliency Initiative. The company also reports that it's outlined extra upcoming efforts.

Following the unprecedented outages of Hurricane Beryl, CenterPoint outlined its GHRI in August. As of last week, the first phase, which included more than 40 critical actions in total to strengthen the electric grid, has been completed ahead of schedule.

The company also announced a second phase of GHRI and approximately $5 billion in resiliency investment from 2026 to 2028, a figure that's around twice as much as initially promised.

"We have heard the call to action from our customers and elected officials, and we are responding with bold actions," says Jason Wells, CenterPoint president and CEO, in a statement. "Our defining goal, going forward, is this: to build the most resilient coastal grid in the country that can better withstand the extreme weather of the future. To achieve this ambition, we will undertake a historic level of resiliency actions and investment, because this is what the people of the Greater Houston area expect and deserve."

According to CenterPoint, the second phase will include system hardening, strategic undergrounding, self-healing grid technology, and further enhancements to the company's outage tracker.

CenterPoint outlined its recently completed efforts, including installing over 300 automation devices and more than 1,000 stronger poles, as well as removing hazardous vegetation from more than 2,000 miles of power lines. Next up, CenterPoint says it's near-term actions will include further grid strengthening, public communication improvements, and enhancements to local, community, and emergency partnerships. The details of this phase, which will take place between September 1 to June 1, will be released by September 30.

In the company's longer-term action plan, CenterPoint commits to $5 billion in upgrades from 2026 to 2028 — "the largest investment in Greater Houston infrastructure in the company's nearly 160-year history."

"The mission of this longer-term plan of action is to build the most resilient coastal grid in the country by investing in a smarter grid of the future that can better withstand a broad spectrum of risks," reads the statement. "The proposal, and the entire scope of these actions will be outlined in a new system resiliency plan that is expected to be filed with the Public Utility Commission of Texas on or before January 31, 2025."

CenterPoint reports that lawmakers have received this information directly, and that the plan will be shaped by feedback from its customers, experts, and stakeholders, including elected officials and local agencies.
